Stage 5 – Implementation / Construction

Capstone Design

Imron Rosyadi

Stage 5 – Implementation / Construction

Capstone Design Course – From Needs to Validated Systems using the V‑Model & ISO/IEC/IEEE 29148

Focus of this session: Stage 5 – Implementation / Construction

DCP‑400 – Implementation Package

Session Learning Objectives

By the end of this session, you will be able to:

  1. Explain how ISO/IEC/IEEE 15288 and 29148 define and constrain the Implementation process.
  2. Describe what configuration management (CM) means in a capstone project and why it matters during implementation.
  3. Identify the main activities of Stage 5 (Implementation / Construction) and relate them to the V‑Model and earlier stages.
  4. List the key deliverables of Stage 5, including what goes into DCP‑400 Implementation and how IMP-* items appear in the RTM.
  5. Apply these ideas to typical ECE capstone projects (e.g., embedded controller, RF or mixed‑signal board, FPGA/DSP design, IoT system).

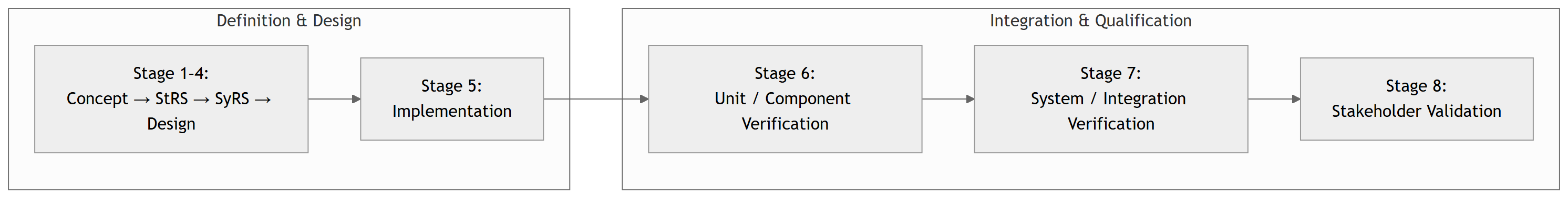

Where Are We in the V‑Model?

Note

Stage 5 is the bottom of the V: You turn design descriptions into working hardware, firmware, and software.

Standards View: 15288 & 29148 at Stage 5

ISO/IEC/IEEE 15288 – System Life Cycle Processes

Relevant processes for Stage 5:

  • Implementation Process
    • Transform system element specifications into realized system elements (code, boards, FPGA bitstreams, etc.).
    • Confirm that each implementation corresponds to its design description.
  • Configuration Management Process
    • Establish and control configuration items (CIs).
    • Manage baselines, versions, and changes.
    • Ensure the correct items are used in integration, test, and deployment.

ISO/IEC/IEEE 29148 – Requirements Engineering

  • Still relevant in Stage 5 because:
    • Requirements guide what to implement.
    • Requirement changes must be controlled (change requests, impact analysis).
    • Implementation status is recorded in the RTM as REQ-* → CMP-* → IMP-*.

Stage 5 in the Course Framework

Course Stage:

  • Stage 5 – Implementation / Construction

V‑Model Level:

  • Bottom: HW/SW Build

Inputs from earlier stages:

  • Approved StRS and SyRS/SRS (STR-*, REQ-*).
  • Approved Design (DCP‑300) with CMP-* components and interface specs.
  • Initial Test Plan (TST-* planned).

Outputs to later stages:

  • Realized implementations (IMP-*):
    • Source code, HDL, schematics, PCBs, 3D models, configs, scripts.
  • Build & configuration documentation.
  • Updated RTM:
    • CMP-* → IMP-* links.
  • DCP‑400 – Implementation package.

Important

You should not be inventing major new requirements or architecture in Stage 5. If you must, it goes through change control.

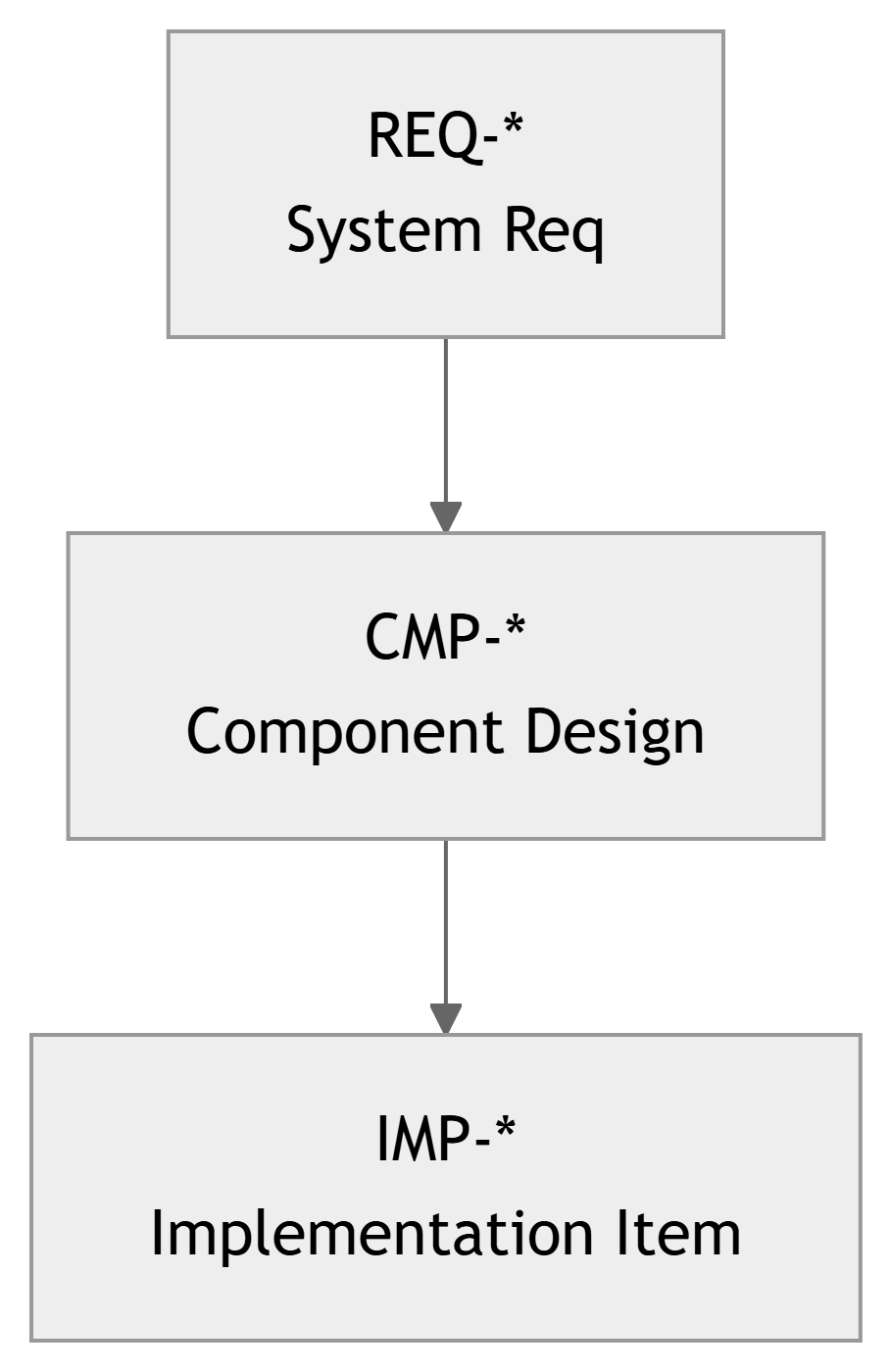

What Is “Implementation” in 15288 Terms?

ISO/IEC/IEEE 15288 – Implementation Process (informal summary):

  1. Prepare for Implementation
    • Confirm design is implementable with available tools, parts, skills.
    • Set up repositories, build environments, toolchains, labs.
  2. Perform Implementation
    • Develop and assemble system elements per design.
    • Follow coding standards, EDA rules, lab safety procedures.
  3. Confirm Implementation
    • Check each built element against its design description.
    • Ensure the implementation is ready for verification (Stage 6).

Note

In capstone terms: Implementation is “build what you designed, in a reproducible way, and prove you’re ready to test.”

What Is Configuration Management (CM)?

Configuration Management (from 15288 CM process):

  • Identify the configuration items (CIs) that make up your system.
  • Define baselines: snapshots of CIs at key milestones (e.g., end of Stage 4, Stage 5 TRR).
  • Control changes:
    • Propose → evaluate → approve/reject → implement → record.
  • Maintain status accounting: who changed what, when, and why.
  • Audit: verify that delivered items match the documented configuration.

Warning

Without CM, you get: - “It works on my laptop.” - “Which version are we demoing?” - “We lost the only working firmware.”

CM in the Capstone Context

Typical Configuration Items (CIs) in ECE capstone:

  • Software artifacts:
    • Source code, libraries, build scripts, Dockerfiles.
  • Hardware artifacts:
    • Schematics, PCB layouts, BOM, mechanical CAD.
  • Programmable logic:
    • HDL, constraint files, synthesis/project files, bitstreams.
  • Configuration data:
    • Calibration tables, config files, lookup tables, FPGA register maps.
  • Documentation:
    • DCP documents, test procedures, user manuals.

CM mechanisms you will use:

  • Git repository (or equivalent):
    • Branches, tags, pull requests, commit history.
  • Versioning schemes:
    • e.g., v0.9-proto, v1.0-TRR, PCB rev A/B/C.
  • Change log / issue tracker:
    • Link issues to REQ-*, CMP-*, IMP-*.
  • RTM updates:
    • Track which requirements are implemented by which IMP-* items.

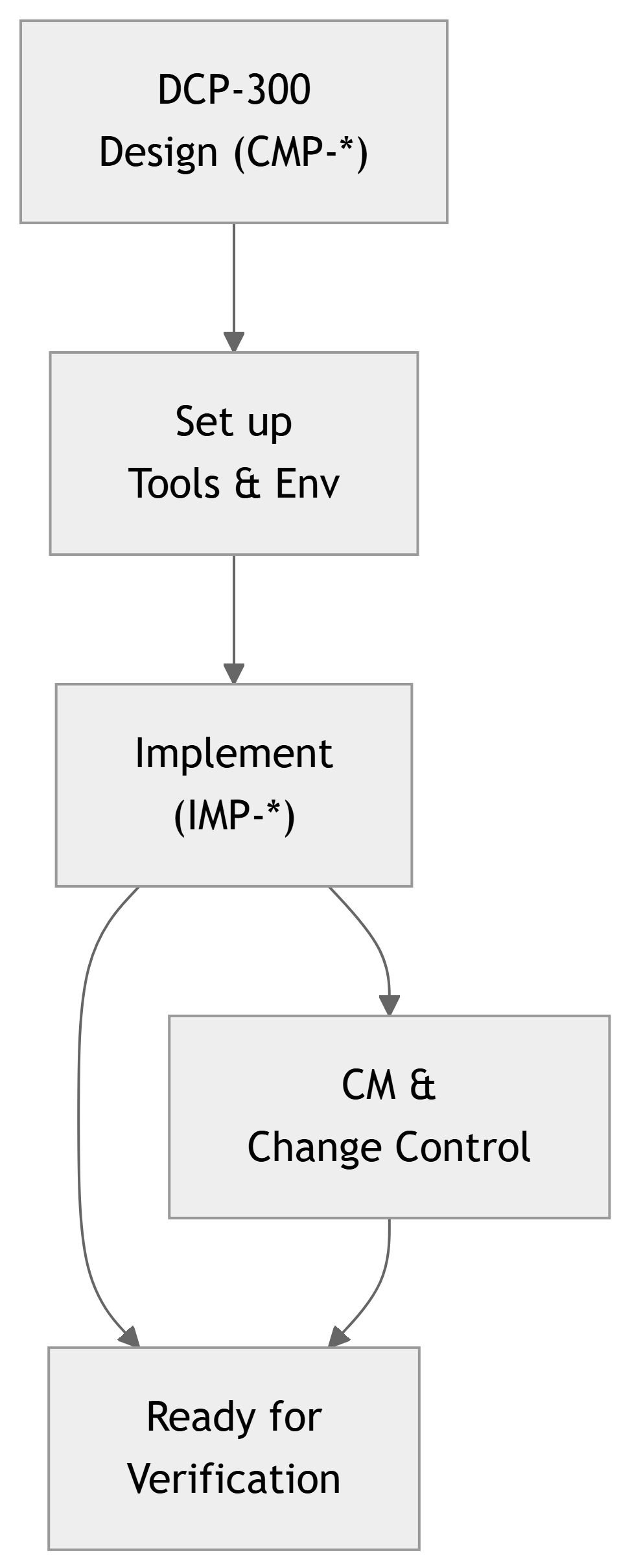

Stage 5 Activities – Big Picture

Key activities in Stage 5:

  1. Set up the implementation environment
    • Toolchains, IDEs, simulators, synthesis tools, PCB vendors, lab benches.
  2. Implement components (IMP-*)
    • Coding firmware/applications/FPGA logic.
    • Building and assembling PCBs and hardware prototypes.
  3. Perform internal checks
    • Smoke tests, static analysis, code review, bench bring‑up.
  4. Manage configurations and changes
    • Use Git, track issues, maintain change logs.
    • Keep RTM synchronized with evolving implementation.

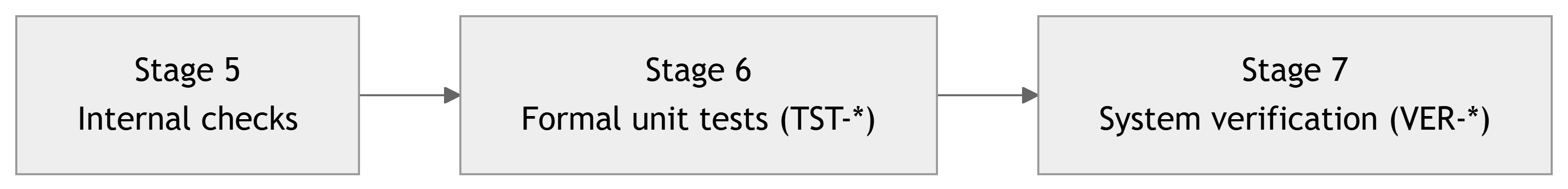

  5. Prepare for Unit/System Verification
    • Ensure build is repeatable and documented.
    • Ensure component implementations match design (CMP-*).

DCP‑400 – Implementation Package (Overview)

Main artifact for Stage 5:

  • DCP‑400 – Implementation

Typical contents:

  1. Implementation Overview
    • Summary of what was implemented relative to DCP‑300.
  2. Implementation Items List
    • Table of IMP-* items and links to CMP-*, REQ-*.
  3. Build & Deployment Procedures
    • How to build, load, configure, and run the system.
  4. Configuration Management Summary
    • Repository location, branches, tags.
    • List of baselines and CI identifiers.
  5. Change Log
    • Approved changes to requirements and design that affected implementation.

Important

If someone gave you DCP‑300 and DCP‑400, you should be able to rebuild the project from scratch.

Example: IMP-* Entries in the RTM

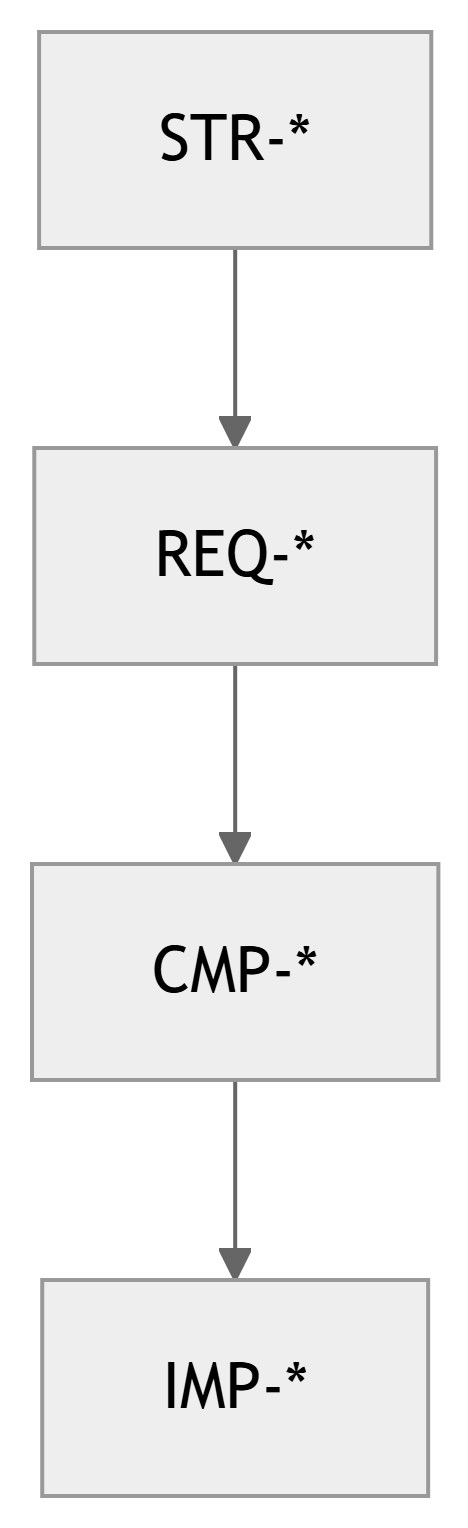

Traceability extension at Stage 5:

Previously:

  • STR-* → REQ-* → CMP-*

Now we add:

  • CMP-* → IMP-*

Example rows in RTM:

CMP ID IMP ID Description
CMP-SW-010 IMP-SW-010A UI module (Flutter app)
CMP-SW-020 IMP-SW-020A Control task (FreeRTOS C module)
CMP-SY-030 IMP-SY-030A Sensor PCB rev B (KiCad project)
CMP-SY-040 IMP-SY-040A LoRa gateway firmware (C++)

Tip

Use IDs in: - Commit messages - Issue tracker - Comments in code (// Implements REQ-SW-015 via CMP-SW-020)

ECE Example 1 – Embedded Motor Controller

Project Scenario:

A BLDC motor controller for a small robot arm.

Earlier stages defined:

  • REQ-SY-010: Motor speed shall be controllable from 0–3000 RPM with ±2% accuracy.
  • CMP-SW-020: Motor control firmware module.
  • CMP-SY-030: Power stage & gate driver PCB.

Stage 5 Implementation Tasks:

  • Write firmware for:
    • PWM generation & current sensing.
    • PID speed controller (or FOC if advanced).
  • Assemble power stage PCB, solder drivers and MOSFETs.
  • Bring up current sensors and encoders.

Related IMP-* Items:

  • IMP-SW-020A: motor_ctrl.c / motor_ctrl.h implementing speed loop.
  • IMP-SW-020B: current_sense.c with ADC driver and calibration.
  • IMP-SY-030A: Assembled PCB rev B with BOM v1.1.

Configuration Management:

  • Git repo for firmware with tags:
    • v0.3-proto-pwm-only
    • v0.5-closed-loop
  • PCB project with revision labels:
    • motor_board_revB, BOM file versioned.

ECE Example 2 – FPGA‑Based DSP Filter

Project Scenario:

FPGA card that performs real‑time FIR filtering on an audio stream.

Earlier stages defined:

  • REQ-SY-020: The system shall implement a low‑pass FIR filter with 60 dB stop‑band attenuation at 8 kHz, fs = 48 kHz.
  • CMP-HW-010: FPGA top‑level design.
  • CMP-SW-030: Coefficients generator / control interface software.

Stage 5 Implementation Tasks:

  • Write HDL modules:
    • fir_core, axi_stream_if, clk_gen.
  • Generate filter coefficients with Python/MATLAB script.
  • Synthesize and place‑and‑route for chosen FPGA.

IMP-* Items & CM:

  • IMP-HW-010A: HDL sources in /hdl/fir_core/, Git repo tag fpga-fir-v1.0.
  • IMP-SW-030A: gen_coeffs.py script version 1.2, with config file for 8 kHz cutoff.
  • IMP-HW-010B: Bitstream file fir_filter_top.bit built from tag fpga-fir-v1.0.

Configuration concerns:

  • Store exact tool versions (e.g., Vivado 2023.2).
  • Store synthesis options & constraints used for the baseline build.

ECE Example 3 – IoT Sensor Network (Smart Lab)

This continues the course’s earlier Smart Lab Sensor Network example.

Recall Requirements:

  • REQ-SY-010: Each sensor node shall measure temperature 10–40°C with ±0.5°C accuracy.
  • REQ-SY-011: Each node shall transmit measurements at least once every 60 s.

Stage 5 Tasks:

  • Implement sensor node firmware (temp/humidity readout, LoRaWAN stack).
  • Implement gateway service and database.
  • Implement dashboard UI.

Implementation & CM:

  • IMP-SW-040A: Node firmware repo with modules sensor.c, radio.c, main.c.
  • IMP-SW-050A: Server backend repo (api.py, db_models.py).
  • IMP-SW-060A: Web dashboard (dashboard.vue).
  • IMP-SY-070A: Node PCB rev C (KiCad project).

Use Git tags: - stage5-demo-node-fw-v0.9 - stage5-demo-backend-v0.7

DCP‑400 references all of these as CIs and explains how to deploy a full test network.

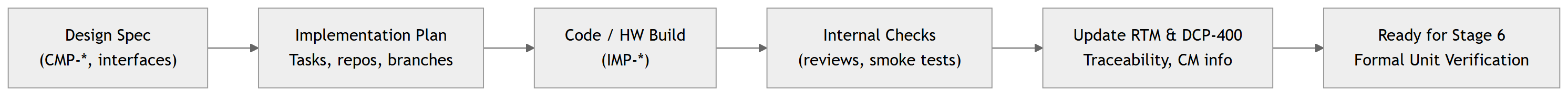

Implementation Workflow – From Design to Code/Boards

Implementation Planning – Breaking Down the Work

From components to tasks:

Example (Smart Lab project):

  • CMP-SW-010 UI module → tasks:
    • Design page layout.
    • Implement dashboard front‑end.
  • CMP-SW-020 control logic → tasks:
    • Implement alert rules engine.
  • CMP-SY-030 sensor board → tasks:
    • Layout rev B, order PCBs, assemble 3 prototypes.

Best practices:

  • Define clear task boundaries aligned with CMP-*.
  • Assign owners for each IMP-* implementation.
  • Use issues/tickets that reference component IDs.

Example Task Table:

Task ID CMP ID Short Description Assignee
T‑501 CMP-SY-030 Layout sensor PCB rev B Alice
T‑502 CMP-SW-020 Implement alert engine Bob
T‑503 CMP-SW-010 Dashboard UI first version Chen
T‑504 CMP-SY-030 Assemble 3 sensor boards Dana

Later, each task produces corresponding IMP-* entries linked back to CMP-*.

Coding and HDL Practices at Stage 5

Software / Firmware / HDL implementation guidelines:

  • Follow style guides (consistent naming, comments, formatting).
  • Embed traceability hints:
    • Comments like // Implements REQ-SW-011, CMP-SW-020.
  • Modularize code according to components (CMP-*).
  • Use unit‑test‑friendly design (dependency injection, test benches).
  • For HDL: use clean module boundaries that match architecture diagrams.

Tip

Think of each IMP-* as a product someone else might reuse. Make it readable, testable, and traceable.

Hardware Build Practices at Stage 5

Hardware implementation guidelines:

  • Keep versioned schematics and layouts; never edit without version control.
  • Label board revisions clearly (e.g., silkscreen “Rev B.1”).
  • Maintain a versioned BOM:
    • Include part numbers, manufacturers, tolerances, and any acceptable alternates.
  • Document assembly process:
    • Which parts are hand‑soldered vs reflowed.
    • Rework steps (e.g., “Cut trace X, add 10 kΩ pull‑up”).

Note

Your PCB rev that works “after some bodges” is still a configuration that must be documented.

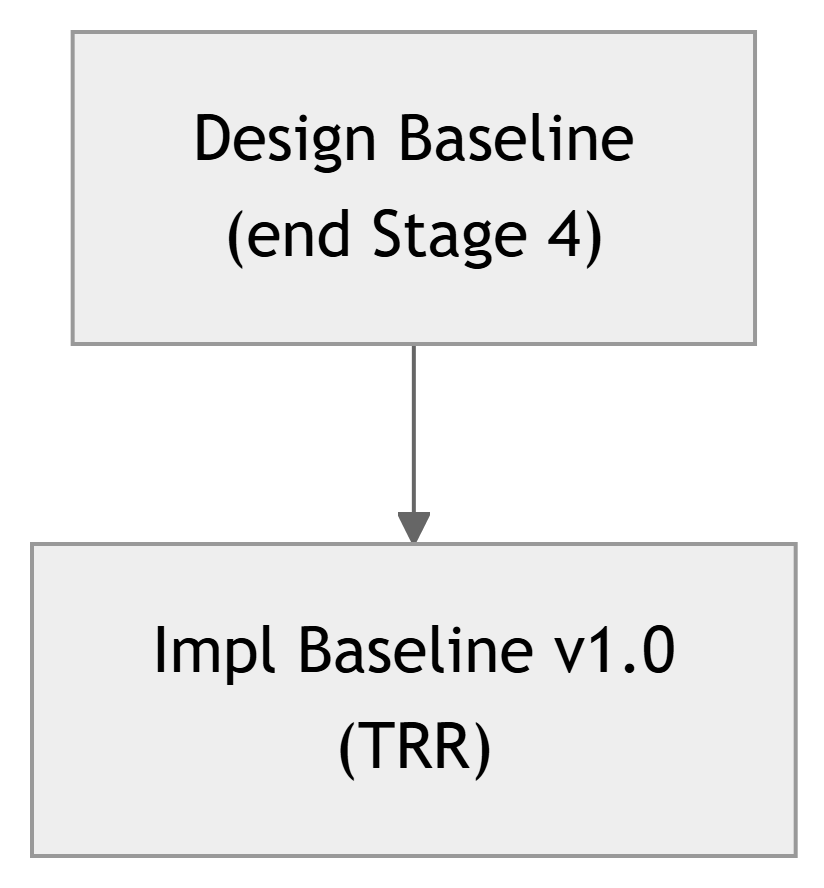

Configuration Baselines in Stage 5

What is a baseline?

A baseline is a formally agreed snapshot of your configuration items (CIs) at a specific time, used as a reference going forward.

Typical baselines at Stage 5:

  • Implementation Baseline for TRR (Test Readiness Review):
    • Tagged Git commits for firmware, backend, and UI.
    • PCB revision and BOM version.
    • Documented calibration/config files.

Important

At the Stage 5 Gate (TRR), you must be able to say: > “We are using these exact versions of code, boards, and configs for verification.”

Change Control During Implementation

Reality: you will discover issues during Stage 5.

Examples:

  • A sensor is noisier than the datasheet claimed → requirement or design may need adjustment.
  • MCU flash is too small → firmware must be refactored or hardware changed.

Change control steps (adapted from 15288):

  1. Raise a change request (CR)
    • Describe the problem and proposed change.
  2. Impact analysis
    • Which REQ-*, CMP-*, TST-* are affected?
  3. Decision
    • Advisor / team approves, rejects, or defers.
  4. Implement change
    • Update requirements/design/implementation.
  5. Update traceability & DCPs
    • RTM, DCP‑200/300/400 updated accordingly.

Warning

Do not silently change functionality. If it affects requirements or design, it must go through change control.

Example Change Request – Smart Lab Project

Problem:

  • Prototype nodes last only 12 hours on battery instead of the 72 hours implied by REQ-SY-0xx (battery life requirement).

Proposed Changes:

  • Change reporting interval from 60 s to 5 min.
  • Add deep‑sleep mode in firmware.

Change Control Actions:

  1. CR‑005 logged referencing REQ-SY-0xx and CMP-SW-020.
  2. Impact analysis:
    • Data latency may affect stakeholder expectations (STR-SY-001).
  3. Stakeholders consulted; they accept 5 min updates.
  4. Approve CR‑005.
  5. Update:
    • REQ-SY-011 text to new 5 min period in DCP‑200.
    • Design (DCP‑300) to include deep‑sleep mode.
    • Firmware implementation (IMP-SW-020B) to include sleep logic.
  6. Update RTM and DCP‑400.

Internal Testing vs Formal Verification

During Stage 5, you will:

  • Run quick checks to see if your implementation basically works:
    • Power‑on tests.
    • Simple functional tests (e.g., “LED blinks”, “UART prints messages”).
    • HDL simulations to see waveforms look reasonable.
  • Fix defects discovered during bring‑up.

These are sometimes called developer tests or smoke tests.

Formal Verification (Stages 6 & 7):

  • Uses planned test cases (TST-*, VER-*) traceable to REQ-*.
  • Follows documented procedures.
  • Has clearly recorded pass/fail criteria.

Note

Stage 5 ends when you have implementations stable enough to enter planned verification.

Documenting Implementation in DCP‑400

Suggested sections (template):

  1. Introduction
    • Scope of this implementation phase.
  2. Implementation Items (IMP-*)
    • Table mapping CMP-*IMP-* → repository paths / file sets.
  3. Configuration Identification
    • Repos, branches, tags, PCB revs, BOM versions, toolchain versions.
  4. Build & Deployment Procedures
    • Step‑by‑step instructions to build firmware/HDL/software and deploy to hardware.
  5. Change Log & Known Issues
    • List of change requests and their status.
    • Known limitations of this implementation (for Stage 6/7 awareness).
  6. Readiness for Verification
    • Statement of which REQ-* are now implemented and ready for testing.

In‑Class Exercise – Map Your Project to IMP-*

Activity (5–10 minutes):

  1. Pick your current or planned capstone project.
  2. Identify 3–5 components (CMP-*) from your Stage 4 architecture.
  3. For each component, propose:
    • A plausible implementation artifact (IMP-*).
    • The repository or file where it will live.
    • Who on the team is likely to own it.

Example answer snippet:

  • CMP-SW-015 – Data acquisition service
    • IMP-SW-015Adaq_service.py in labdaq/backend/ (owned by Sam).
  • CMP-SY-025 – Sensor shield board
    • IMP-SY-025Asensor_shield_revA KiCad project (owned by Alex).

Tip

Use this to plan your repos and tasks early, rather than improvising halfway through implementation.

Summary – Key Takeaways for Stage 5

  1. Stage 5 (Implementation / Construction) is the bottom of the V‑Model, where designs become real HW/SW systems.
  2. ISO/IEC/IEEE 15288 defines the Implementation and Configuration Management processes that guide how you build and control your system elements.
  3. ISO/IEC/IEEE 29148 remains active: implementation must continue to respect and trace back to requirements, and any requirement changes must be controlled.
  4. Your main Stage‑5 deliverable is DCP‑400 Implementation, which documents:
    • Implementation items (IMP-*) and their traceability to CMP-* / REQ-*.
    • Configuration baselines, repos, versions, build procedures, and change log.
  5. Solid configuration management (Git, tags, PCB revs, BOM versions, change control) is essential for:
    • Reproducibility.
    • Reliable verification and validation later.
    • Professional practice aligned with real ECE industries.

Important

Stage 5 is not “just hacking until it works.” It is disciplined construction under configuration control, preparing you for rigorous verification and validation.
